Replacement of the North Avenue Bridge Over I-95 in New Rochelle
This project will replace the North Avenue bridge in the city of New Rochelle. The bridge is located above a section of the New England Thruway (I-95). Approximately 20,000 vehicles use the North Avenue bridge daily.
The existing North Avenue bridge, which has been in service since 1958 and has a lower vertical clearance, has a history of impact damage as well as continued deterioration due to age, wear, and harsh winter conditions. This replacement project is necessary to address structural and operational needs, along with enhancing safety and improving mobility for motorists as well as pedestrians at this critical intersection.
Working closely with the city of New Rochelle, Thruway Authority engineers determined the project should be completed in three stages to maintain access to the heart of the city. Stage 1 will consist of vehicles relocated to the center of the existing bridge so its outermost components can be removed. It will also include the construction of new substructures, erection of steel and placement of concrete decks. Stage 2 will move vehicles to the new outer bridge sections so the remainder of the old bridge can be removed and rebuilt. Stage 3 will move vehicles to the center of the new bridge so sidewalks, paving and other work can be completed.
The project began in January 2023 and is anticipated to be substantially completed in Fall 2025.
Major components of this project include:
- Building a wider structure to accommodate a dedicated North Avenue southbound left turn lane onto Garden Street
- Raising the bridge’s vertical clearance over I-95 to 16’ 6’’
- Converting Burling Lane to one-way from North Avenue to Memorial Highway (westbound traffic only)
- Improving traffic flow on Garden Street
- Installing decorative lighting and fencing, and other architectural treatments given the prominent location in the downtown corridor
- Completing the Burling Lane Park, including an ADA compliant ramp to access the pedestrian walkway over I-95 to the Metro-North train station
- Rebuilding sidewalks and adding benches to both sides of the bridge
During construction, motorists and residents should expect the following:
- Northbound and southbound lanes on North Avenue will be limited to one lane in each direction
- Burling Lane between May Street and North Avenue will be closed for the duration of the project
- First responders, buses and articulated buses, and delivery trucks with three axles or less will continue to have access to the bridge at all times
- Due to space constraints, vehicles with more than three axles will not be allowed through the construction zone; a truck detour is provided

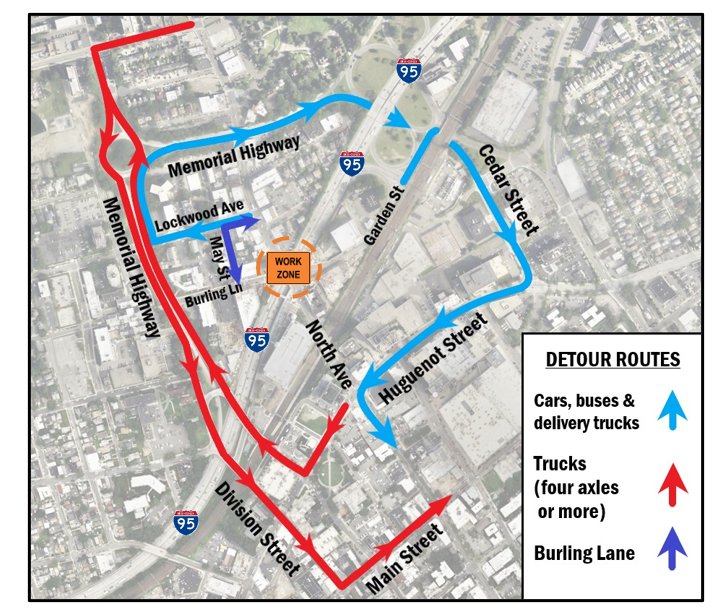

- Left turns from North Avenue to Garden Street will be prohibited; a detour will be provided utilizing Lockwood Avenue to Memorial Highway

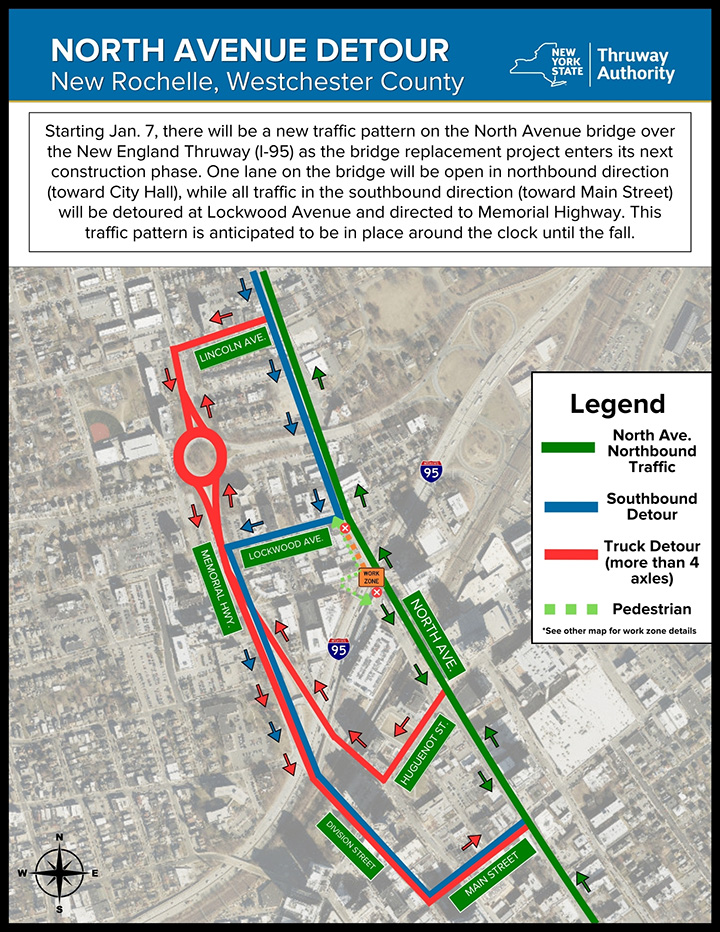

- Left turns from Garden Street to North Avenue will be prohibited; a detour will be provided utilizing Cedar Street to Huguenot Street

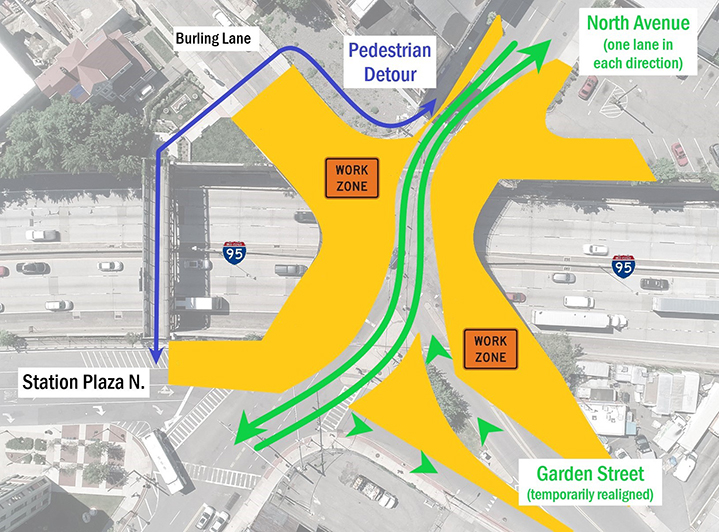

- Pedestrian traffic will be maintained throughout the project using the existing walkway over I-95 connecting at Burling Lane and the train station.
- The majority of construction will take place during the day; overhead work such as bridge deck and steel removal that requires highway lane closures will occur at night for the safety of workers and to limit impacts to traffic.
STAGE 1
- North Avenue Bridge Project Fact Sheet
- June 13, 2024 -- TRAVEL ADVISORY: STEEL INSTALLATION SET TO BEGIN ON NORTH AVENUE BRIDGE IN NEW ROCHELLE ON MONDAY, JUNE 17
- October 26, 2023 -- TRAVEL ADVISORY: DEMOLITION OPERATIONS SET TO BEGIN ON NORTH AVENUE BRIDGE IN NEW ROCHELLE ON MONDAY, OCTOBER 30
- March 6, 2023 -- TRAVEL ADVISORY: NEW TRAFFIC PATTERN SET TO TAKE EFFECT ON NORTH AVENUE BRIDGE IN NEW ROCHELLE ON WEDNESDAY, MARCH 8
- January 12, 2023 -- THRUWAY AUTHORITY ANNOUNCES START OF $31.8 MILLION BRIDGE REPLACEMENT PROJECT OVER I-95 IN WESTCHESTER COUNTY
Rendering of North Avenue Bridge

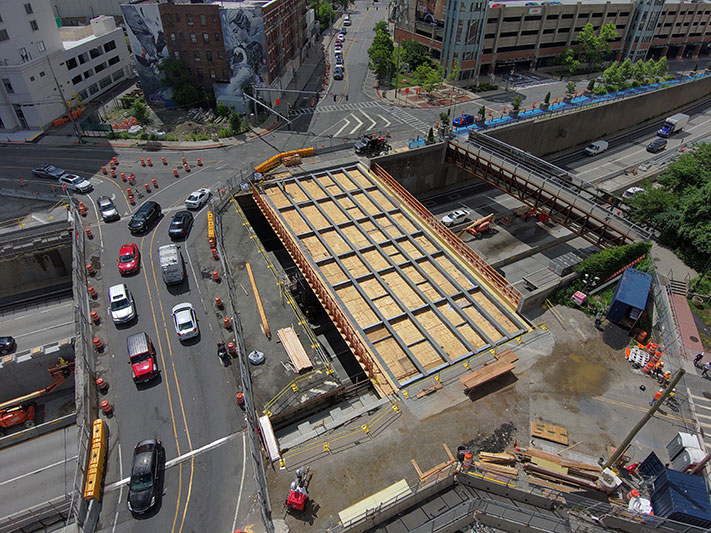

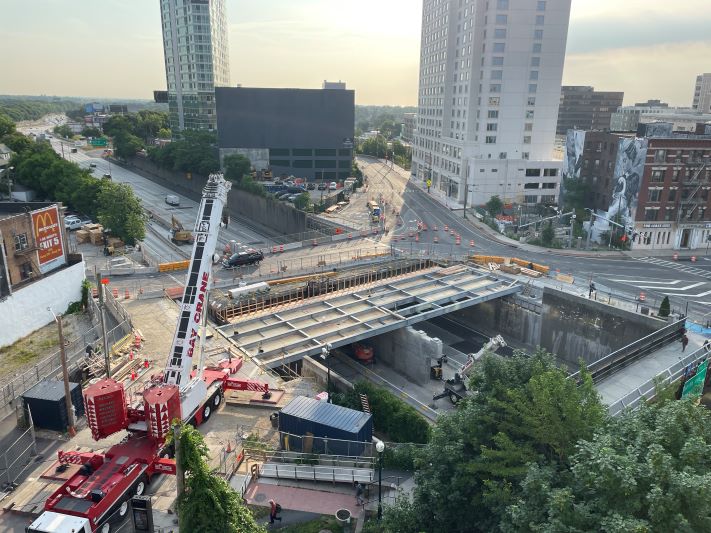

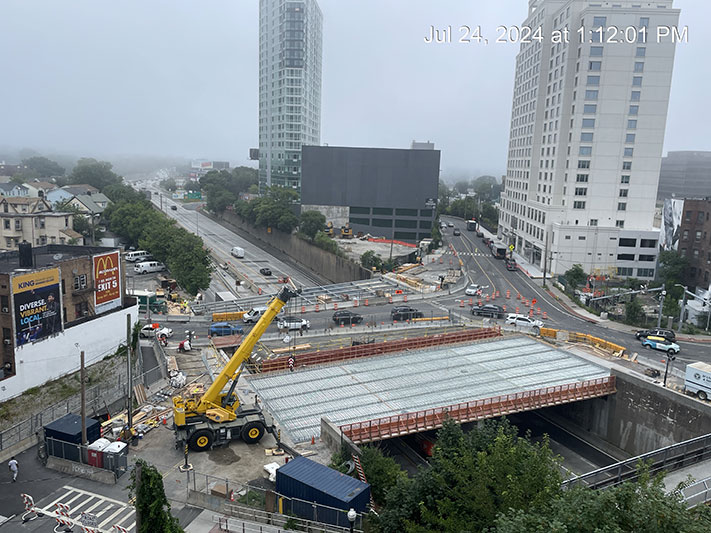

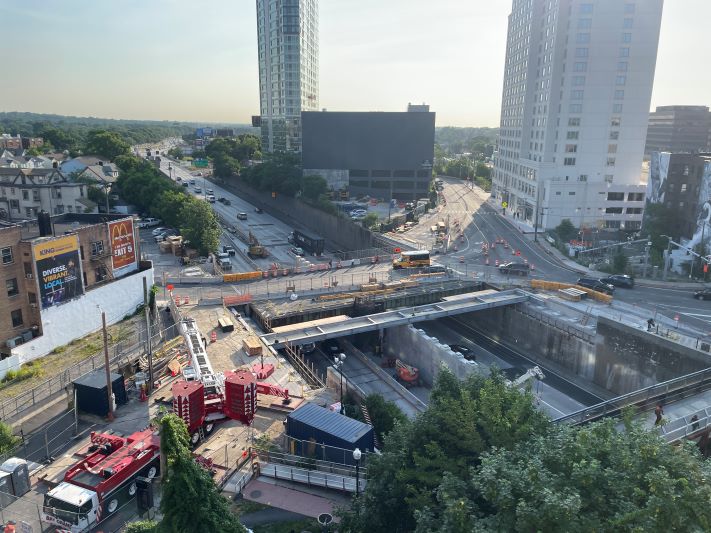

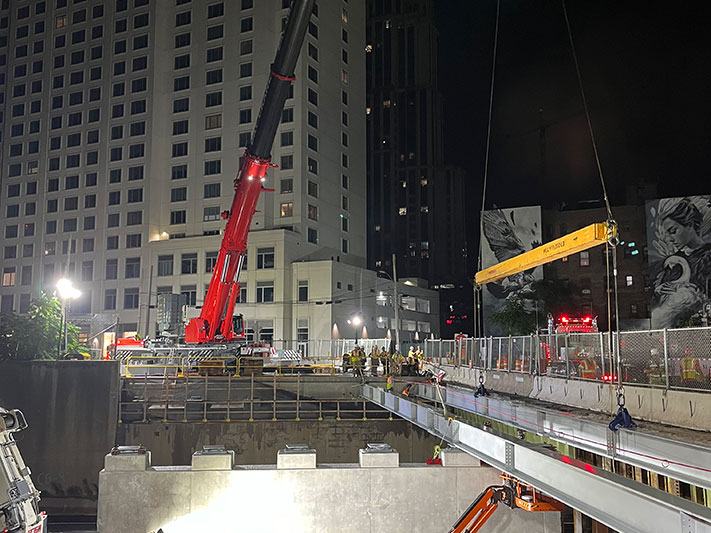

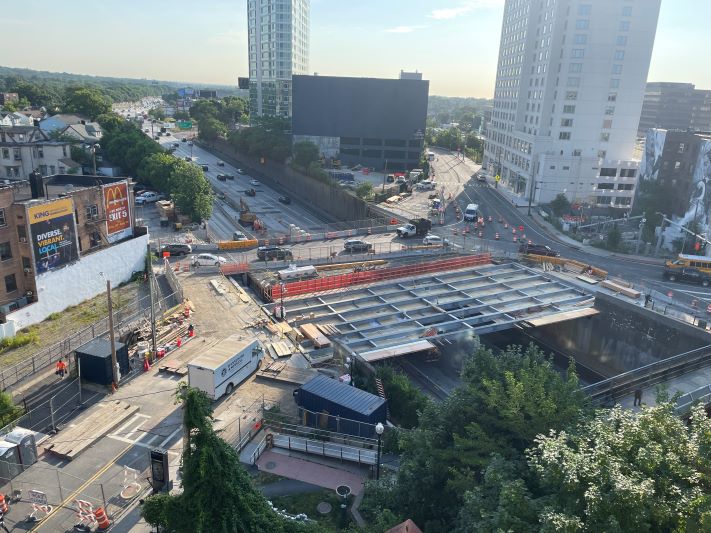

Steel Installation July 2024
Steel Installation July 2024
Steel Installation July 2024
Steel Installation July 2024

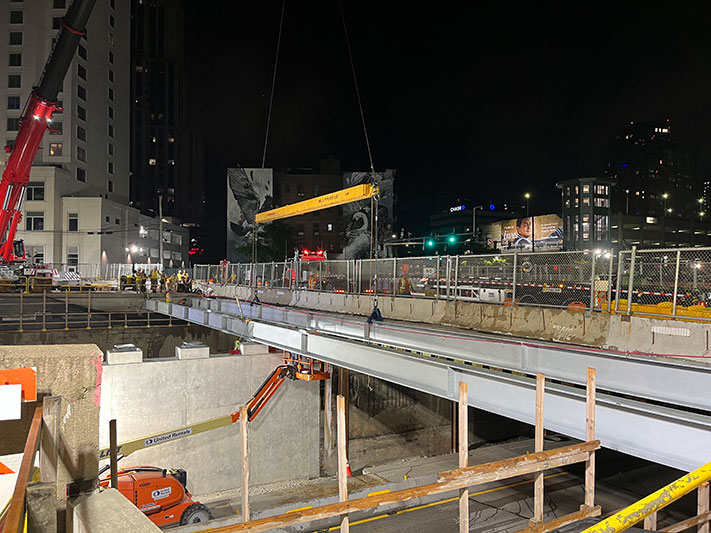

Steel Installation June 2024
Steel Installation June 2024
Steel Installation June 2024

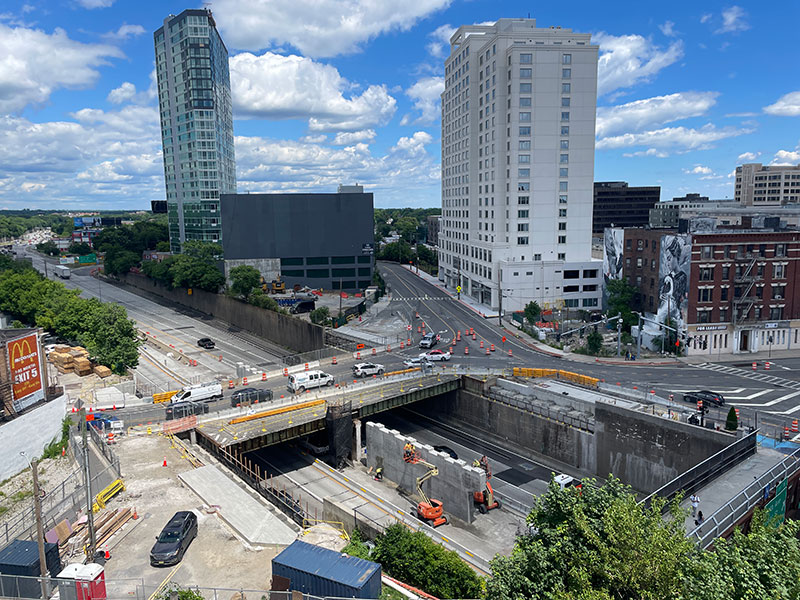

June 2024

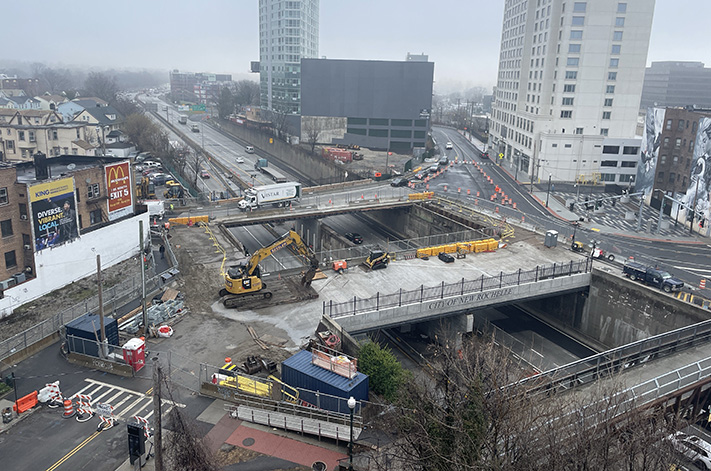

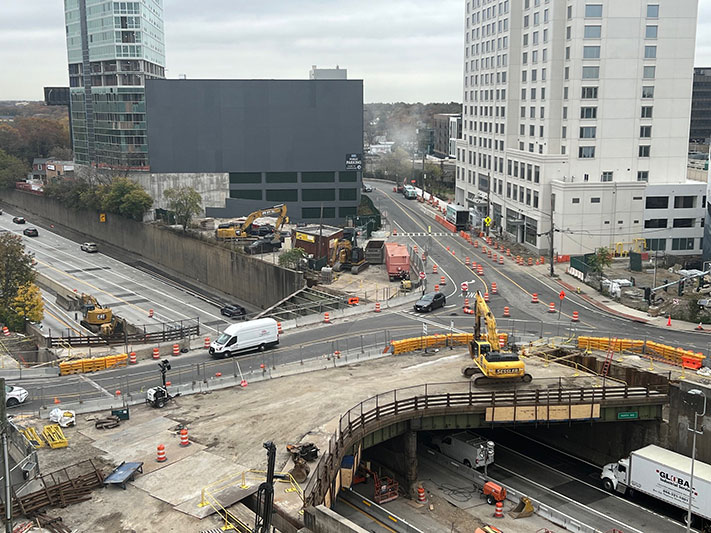

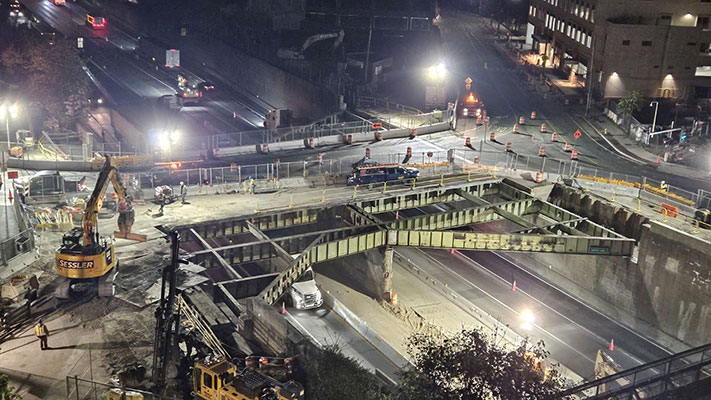

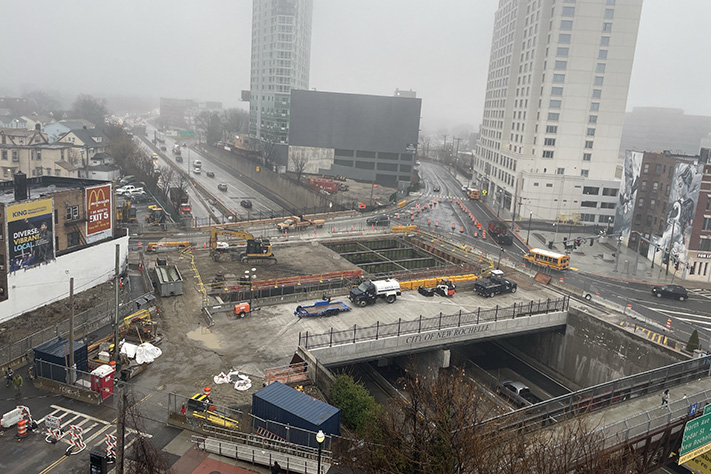

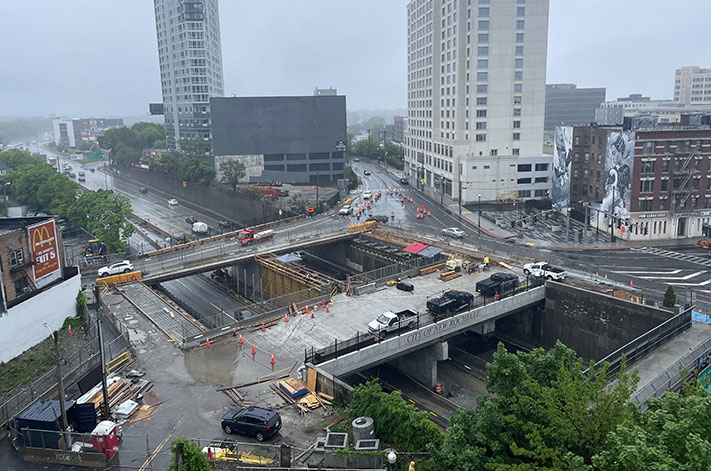

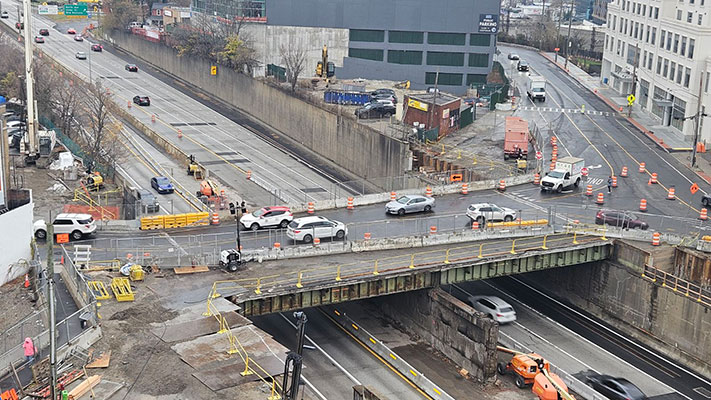

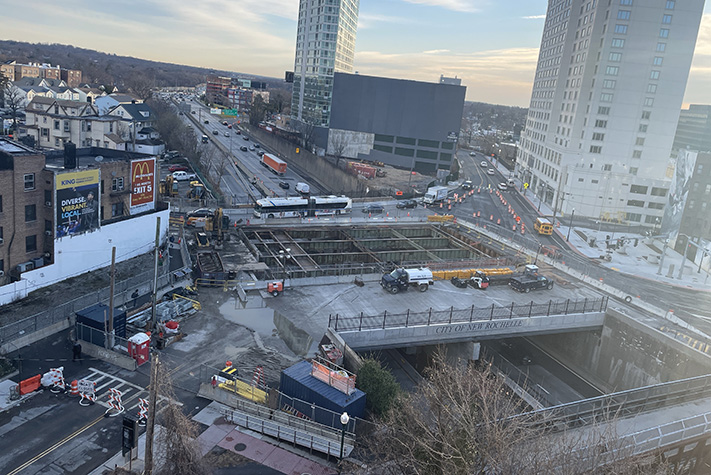

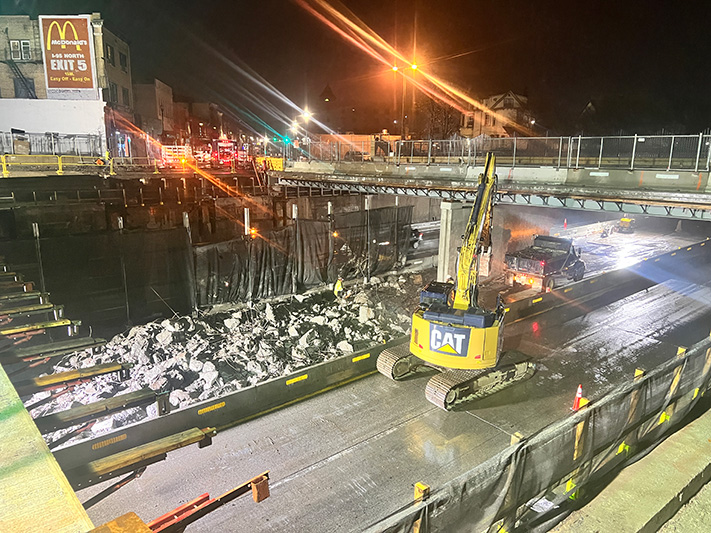

Demo Work 2023
Demo Work 2023
Demo Work 2023
Demo Work 2023
May 2023

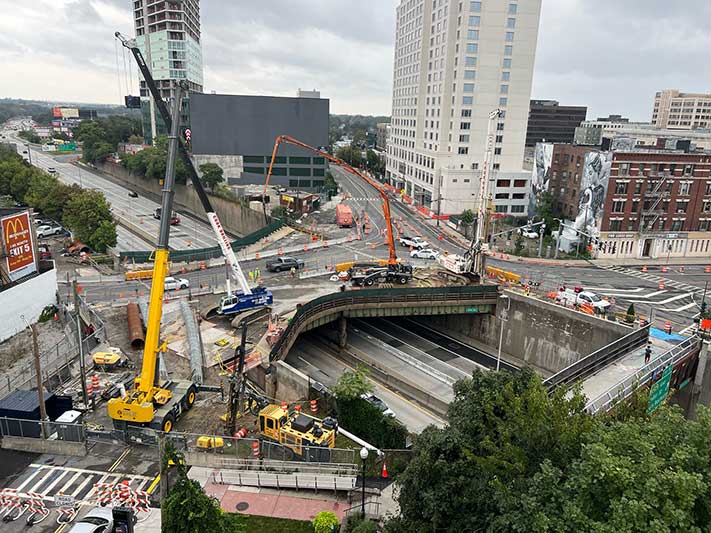

Project Overview - Concrete Pour

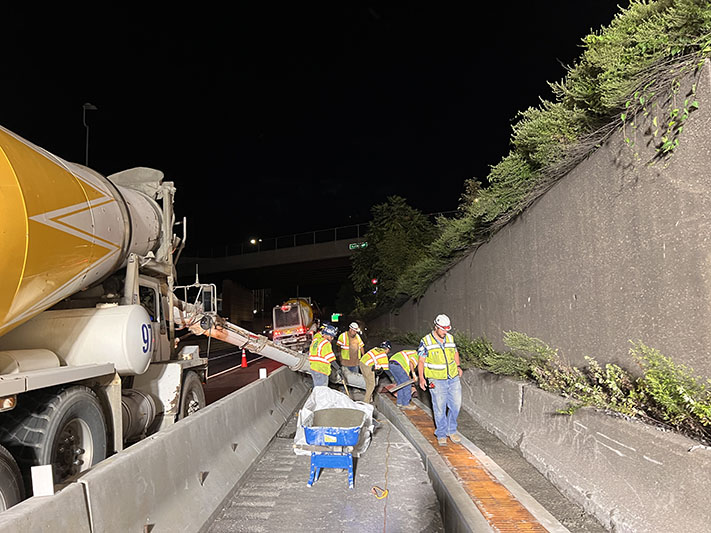

Trench Drain Installation

Pressure Grouting
Shoring Towers Work

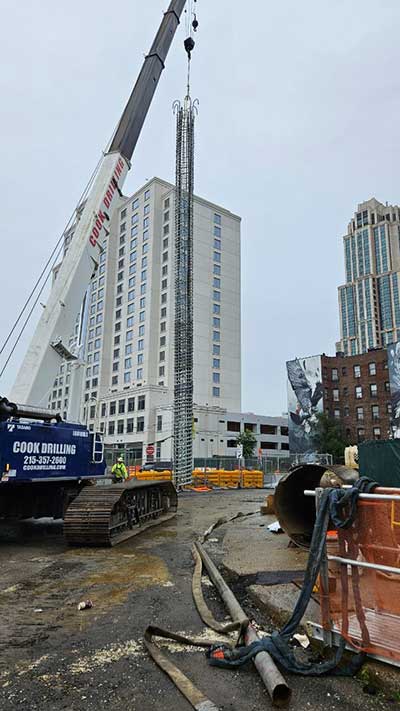

Drilled Shaft Reinforcement

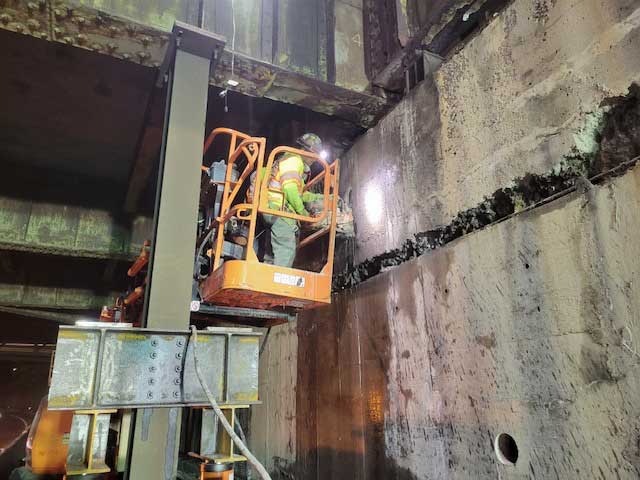

West Abutment Work
